Workback Plan Template: A Tool to Prevent the Last-Minute Scramble
This workback plan template prevents chaos and last-minute scrambles.
This is part of a series on optimizing processes to enhance your impact
Process Improvement
How To Scale With Business Process Optimization
Contract to Cash: Why Social Impact Leaders Should Care
How to Build Accountability in a Team: Your Essential Guide
How To Achieve Financial Sustainability Without Sacrificing Impact
How to Prevent Scope Creep in Your Innovation Strategy
Streamlining Project Initiation: An Essential Checklist
Contract to Cash: Why Social Impact Leaders Should Care
How to Build Accountability in a Team: Your Essential Guide
How To Achieve Financial Sustainability Without Sacrificing Impact
How to Prevent Scope Creep in Your Innovation Strategy
Streamlining Project Initiation: An Essential Checklist
Team & Execution
AI
A Simple Workback Plan Template for Busy Teams
Your team is talented but stuck in reactive firefighting. Deadlines appear suddenly, stakeholders micromanage, and every day feels like a scramble.
To break free, you need more than a to-do list—it’s just a list of chaos.
This guide shows you a strategic workback plan template. You start with the final deadline and work backward, building a clear path from that date to today. It creates a shared, proactive plan that gives you clarity and control to deliver great results, even under pressure.
Key Takeaways
- Work backward from your deadline: Anchor your plan to the final due date. This turns your plan from a hopeful idea into a clear, achievable schedule.
- Go beyond a simple timeline: A strong workback plan includes a clear "Definition of Done" to keep everyone accountable and a "Status" tracker to show visible progress and build trust.
- Keep the plan alive: Your plan isn’t set in stone. Use it as a living tool to manage risks and keep moving forward.
Workback Plan Template: A Step-By-Step Guide
Step 1: Define the "Single Source of Truth" (The "What")
We've all been in that meeting where someone's using an outdated to-do list, another is looking at a different "master plan," and a key leader isn't sure which one is the real source of truth. To fix this messy mix-up, the first step is to create a clear, complete list of every major deliverable for the project.
- The "Order" Column: This simple numbering system shows task order and priority, so team members avoid working on low-priority tasks first.
- The "Project" Column: Use this to group related tasks into clear workstreams like "Plan" and "Prioritize," fixing the problem of a long, confusing list.
- The "Deliverable" Column: List every tangible item you need to deliver, like "Workback Plan" or "Final Deck," in its own row.
An overlooked key to success is chunking big deliverables down.
Break down large, complex deliverables into reasonable chunks (e.g., "Workback Plan - Guide & Template," "Workback Plan - Build out & Align") to spread the work out and ensure key steps actually happen. However, be careful to not turn this into tasks, which will make the plan chaotic and cluttered.
- The “To Do List” Column: Holds the smaller tasks needed to finish each deliverable, grouped for easy tracking.
Here’s the grouped “To Do List Column” in action.

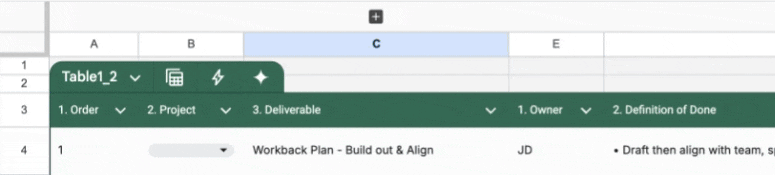

This creates a clean + icon in the header, allowing you to instantly expand and collapse the detailed to-do list for any milestone, enabling access while keeping the main view clean.
Process Tip: Update & share this plan regularly to build a single source of truth.
A plan is useless if it’s just something just sits in a folder (like many slide decks). The real magic comes from using the plan as a living, dynamic tool that is continuously referenced and used to drive the project forward.
- Less Productive: The team meets, but everyone is working off a different, outdated to-do list, leading to a confusing and unproductive conversation.
- More Productive: The project lead updates the plan before every meeting and sends a link to it in advance for the team to review before the meeting. The meeting starts, and the plan is shared on the screen to quickly knock out key action items; everyone has already reviewed it before the meeting and is working from a single, shared source of truth, not creating their own internal, different planning docs.
Step 2: Build a "Proactive & Achievable" Timeline (The "When")
Let’s say the team only looks at what's due this week, ignoring a huge workload "spike" three weeks away. They are caught by surprise and miss the deadline when it happens. This section is the direct antidote to this "Last-Minute Scramble." Now that we know what we need to do, we need to create a realistic timeline based on our hard deadline.

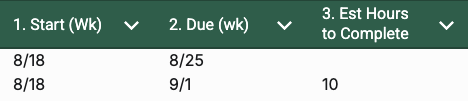

- The "Start" and "Due" Columns: First, go to your plan’s last row and enter your final, non-negotiable project deadline in the "Due" column (like 9/1). This is your anchor.

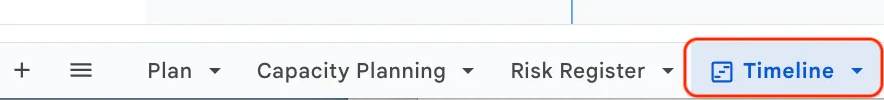

- To get there, click on the Timeline Tab at the bottom of the sheet.
- This timeline updates automatically from the dates you enter in the Plan Tab, giving you one reliable source that stays current.
Next, work backward from that anchor deadline.
Set realistic dates for each task based on what you know. This turns your wish list into a practical schedule. Consider adding anonymized task details and Definitions of Done (see below) into an AI tool to help estimate durations and suggest timelines. I recommend using the week’s Monday date to track progress week by week, just in case your timing is a bit off.

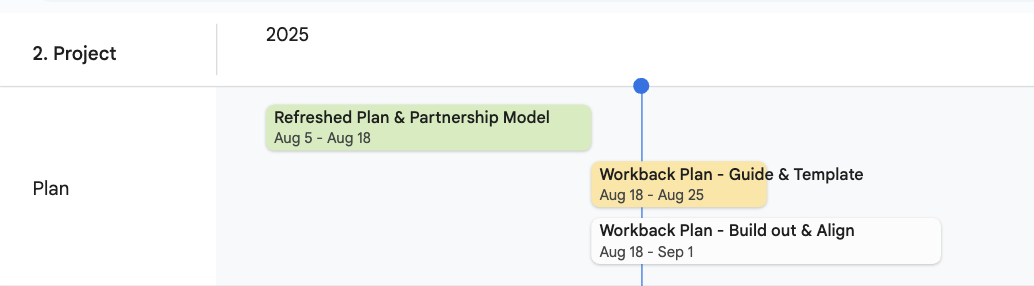

With these columns, you can create a handy, always-updated Timeline.
A visual timeline is the great way to show the big picture and “gut check” whether the sequencing and timing of the project makes sense.
- The "Estimated Hours to Complete" Column: This helps you estimate time for key tasks so you can better plan and manage your workload.
Process Tip: Three steps to avoid the last-minute scramble above.
- The project lead uses the "Capacity Planning" pivot table tab at the bottom of the sheet.

- They spot a 30-hour workload spike for the owner in two weeks (9/15).
- Since they track the team’s weekly hours, they know the team usually handles about 20 hours. Plus, a key teammate will be on PTO, raising the risk of falling behind.

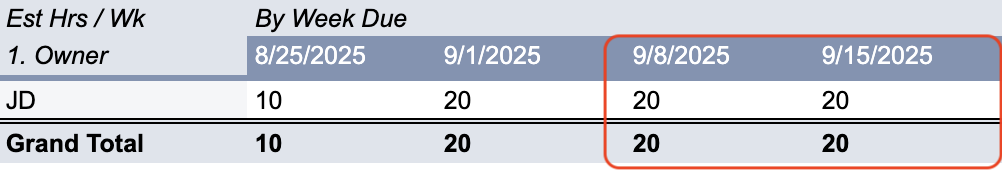

- The simple fix: move a 10-hour project due 9/15 to 9/8, balancing the workload at 20 hours each week instead of 10 one week and 30 the next.
- The lead took the initiative to start a conversation. Everyone involved agreed to adjust the schedule, keeping the team informed and making the 9/15 deadline more achievable.
- (Another option is splitting the deliverable into smaller parts and spreading them across weeks—see the prior section for more on that strategy)
Step 3: Create "Clear Accountability" (The "Who")
Imagine a key deliverable is marked 'Done,' but the project lead finds out the Engineering Manager never saw it. Now the work must be redone last minute, causing a week-long delay and missing the release deadline. To stop the blame game and prevent dropped balls, these columns set a clear social contract for the team.
- The "Owner" Column: Every deliverable has one clear owner. When someone’s clearly responsible, the task gets done.
- The "Definition of Done" (DoD) Column: This sets a shared agreement on what "done" means, so there’s no confusion. It also spells out who you need to align with.
A common mistake is to confuse a "Definition of Done" with a simple to-do list.
A task list tells you what to do; the Definition of Done tells you what 'good' looks like. Use the DoD for your high-level quality outcomes (e.g., "Signed off by X"), and nest the detailed, step-by-step "to-do" list in the grouped "To Do List" column.

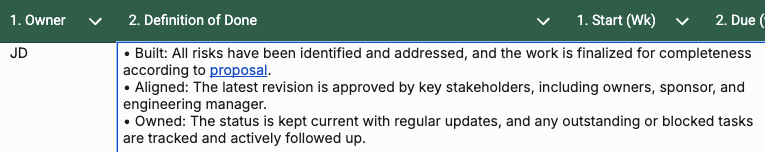

Let’s revisit the earlier example. The plan’s Definition of Done now clearly includes the checklist item: 'Approved by key stakeholders such as the engineering manager.' The task owner makes sure this happens before completing the task. The brief then passes the final approval smoothly, with no surprises.
Process Tip: Empower Owners to Refine and Validate Their Own "Done.”
A plan is not a top-down command; it's a collaborative agreement. To build true ownership, the deliverable owner—the person closest to the work—should be responsible for finalizing their own "Definition of Done."
- Less Productive: A deliverable owner is assigned a task with a vague "Definition of Done." They spend two weeks building what they think is the right thing, only to find out in the review that it was a complete misinterpretation.
- Productive: The deliverable owner refines a clear, bulleted "Definition of Done" and validates it with their audience (e.g., key stakeholders that will consume it, the project lead) before starting. The project lead has a quick, 5-minute async check-in to confirm the DoD is robust, ensuring the owner builds the right thing, the first time.
Step 4: Show "Visible Progress" (The "How It's Going")
We've all experienced this: after two weeks of silence, a senior leader suddenly emails for an urgent update. The team scrambles, spending hours on a status report and putting other work on hold. This guide helps you handle last-minute requests and build confidence proactively.
- The "Key SH Alignment" column: Tracks the risk of stakeholder misalignment as a clear metric, reminding deliverable owners to get key items aligned with decision makers or target audiences before marking them complete.
- The "Status” Column: Solves the “Is this done?” question with a simple, color-coded status that gives an instant project health check.
Now, imagine the senior leader above checks the shared workback plan. Instead of worrying, they send a friendly note: "I see you’re you’re blocked. Let me know if I can help.” (Ideally, when something’s truly blocked, the deliverable owner should ask for support right away.)
Process Tip: Own and Drive Progress
The project manager’s main job is to refer back to the plan and clear any obstacles for the team. This helps keep the plan fresh and used by the team as a real single source of truth.
- Review the plan continuously, bringing up items async to help unblock and drive progress forward.
- Protect time to review the plan in key meetings, focusing on things that couldn’t be handled asynchronously.
Extra Credit for Managing Up: To keep senior stakeholders feeling confident and informed, create a simple regular async report before they ask for it. Build one by asking each owner to regularly send:
- Confidence: the % chance they’ll meet their next key projects’ due dates,
- Blockers: their top 1-2 unresolved blockers or risks, and
- Wins: their biggest project win — including the projects (or major progress) they achieved since the last update and whether it matched their expectations.
Step 5: Mitigate Risks (The "...What If?")
This final step solves for the classic "Oh Shoot!" moment when a hidden dependency or a massive workload spike is discovered a week before the deadline, when it's too late to fix. A great plan doesn't just list what needs to be done; it actively hunts for and mitigates risks.
First, go to the "Risk Register" tab at the bottom of your sheet.

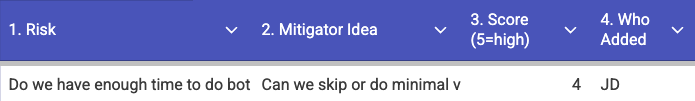

- The Risk Column: This is the concern or worry that could cause the project to fail.
- The Mitigator Column. This is an idea that would mitigate or prevent that risk.
- The Score Column. The risk’s importance, enabling prioritization.
- The Who Added Column. Using this, the lead can follow up to clarify the risk.
TIP: Ask all owners, especially the project lead/manager, to review the plan for these three risk types—and update the risk register.
- Capacity: Do we have enough time, budget, or skills to do this well?
For example: Are we being too optimistic about how fast we can finish or how much can fit in a week or the entire project? Or is someone using an inefficient approach?
- Dependencies: Are there people, factors, or steps we need to address sooner?
A common case is getting buy-in from a key stakeholder or teammate. Or new policies that might change what or how we work.
- Value: Are we aiming at the right goal, problem, or deadline?
For example, maybe the goals have changed without us knowing, or we misunderstood the deadline. These are worth double-checking.
If these risks can’t be resolved asynchronously, the project lead should raise them promptly in key meetings with mitigator ideas in hand.
FAQ on Our Workback Plan Template
What is a workback plan?
- A workback plan (or workback schedule) is a project management tool where you start from a fixed deadline and work backward to map out all the tasks and milestones needed to meet that deadline.
What should be included in a project plan?
- A great project plan includes more than just tasks and dates. As shown in our deep dive, it should also include clear owners for each task, a "Definition of Done" to ensure accountability, and a status tracker to provide visible progress to stakeholders.
How do you manage a project with a tight deadline?
- The key is to be ruthless about prioritization and to have a proactive capacity plan. First, use a framework to ensure you are only working on the absolute most essential tasks. Second, use a capacity planning tool (like the "Advanced Application" described above) to identify and smooth out "spiky" workloads before they become a crisis.
Why use a Sheet instead of a dedicated tool like Asana or Jira?
- You'll notice this guide refers to a simple sheet as its primary example. This is a deliberate choice for projects with small, but busy teams. While tools like Asana, Jira, or Monday are powerful, they can be complex, costly, or blocked by IT—often creating more work instead of less. This guide shows you how to build a clear project plan using free, secure, and familiar tools your team already knows.
Get Your Free Toolkit
Put the framework into practice now with:
- A step-by-step Worksheet to guide your analysis
- Powerful AI Prompts to enhance your thinking
- A Worked Example showing the framework in action
• • • • • • • • • • • • • • • • • • • • • • • • • • • • • • • • • • • •
• • • • • • • • • • • • • • • • • • • • • • • • • • • • • • • • • • • •
